AltadenaUnder Construction July 2026

Multi-Unit Residential on Ganesha Avenue

Drainage plans, hydrology report, and street plans for a multi-unit residential fire rebuild following the Eaton Fire.

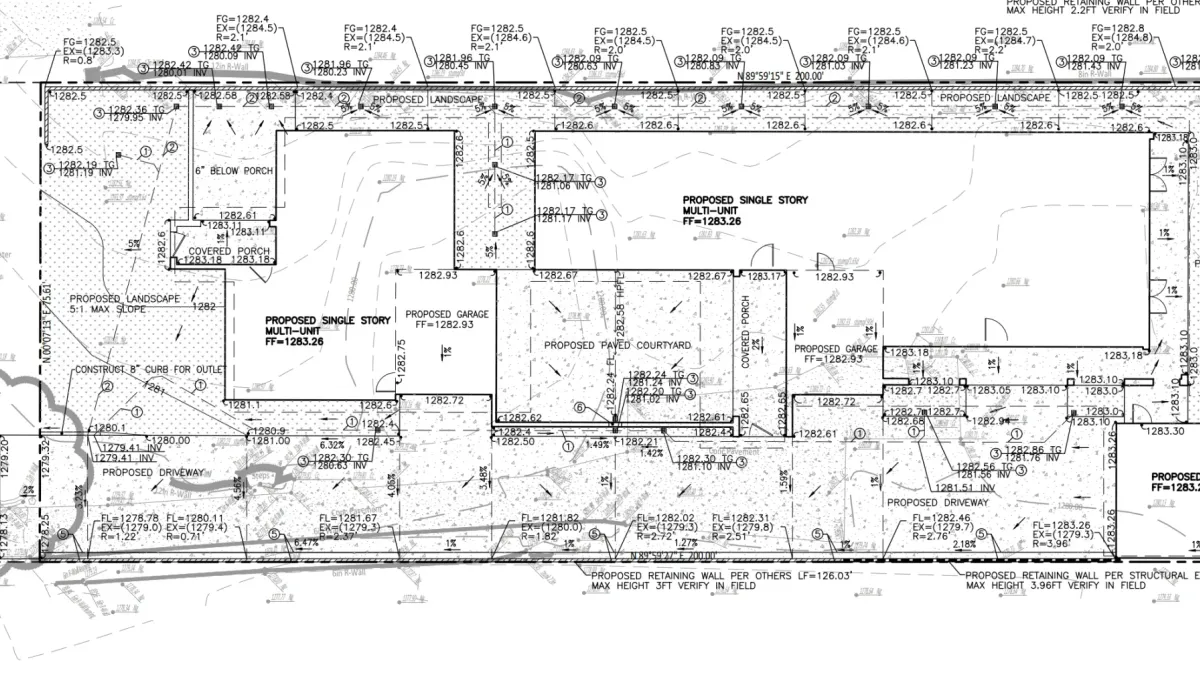

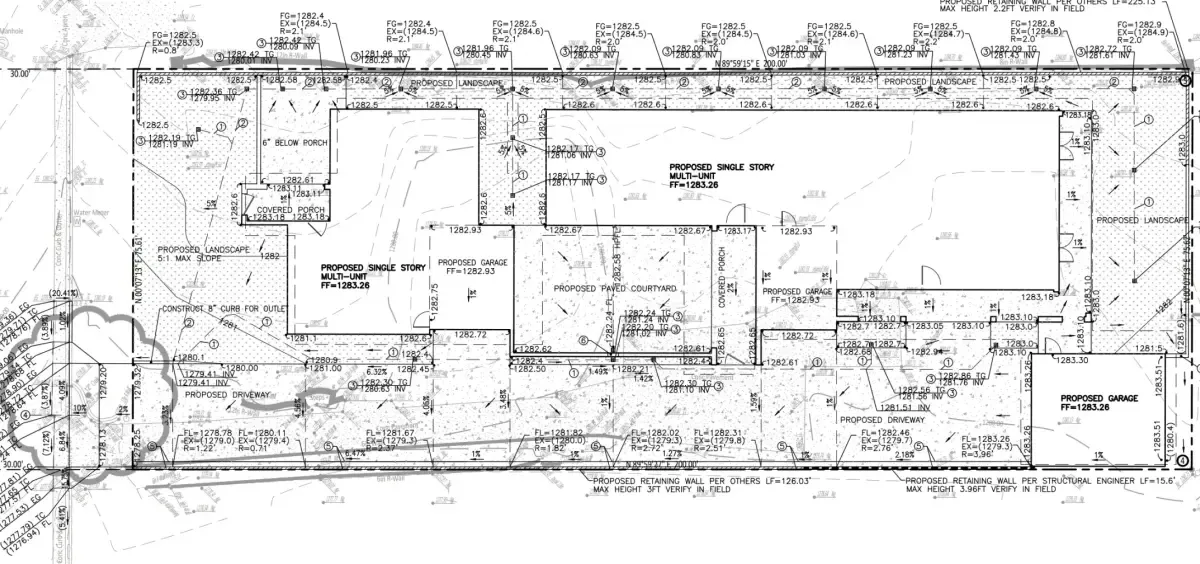

Drainage plan for Altadena multi-unit residential project showing drainage layout and street plans

Location

Altadena, CA

Current Phase

Under Construction July 2026

Project Overview

Multi-unit residential fire rebuild in Altadena following the Eaton Fire. This sideways lot has the entrance on the West side with topography sloping North to South. There is about a 6-foot drop North to South over a 75-foot run, creating enough slope to work with for gravity drainage. The structure is longer than a typical house, requiring careful consideration of how stormwater moves across the site. We used gravity drainage wherever possible with only minor interventions needed at the lowest points. Short walls on the North and South sides balance the building in the middle and provide just enough elevation to get gravity drainage from the rear to the front. A unique challenge was the driveway apron design, which required adjusting the flowline to work around a concrete slab acting like a little bridge over the street flowline. We created a flowline that blended into the apron at 1% minimum while maintaining standard curb and gutter crossslope. The drainage ultimately flows into a plastic-lined rain garden at the rear corner of the lot. A hydrology report demonstrates post-development flows match pre-fire conditions, avoiding the need for a stormwater sump pump.

Site Photos

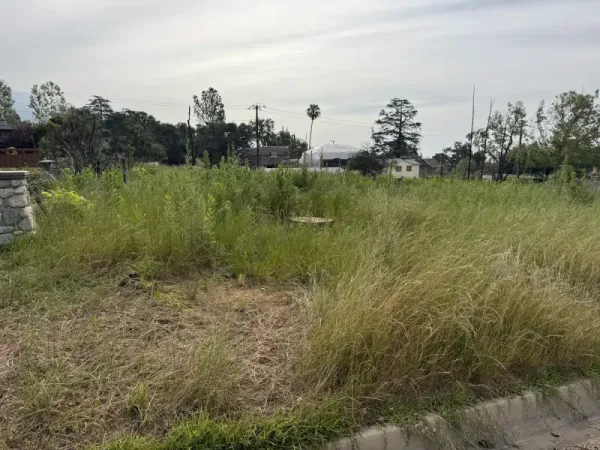

Overgrown vacant lot in Altadena with cracked concrete driveway and mountain views for multi-unit fire rebuild

Pre-construction site photo of Altadena multi-unit lot showing concrete driveway slab over drainage ditch

Overgrown vacant lot in Altadena with tall grass and weeds for multi-unit fire rebuild project

Altadena vacant lot with dry grass and weeds showing San Gabriel Mountains backdrop for fire rebuild

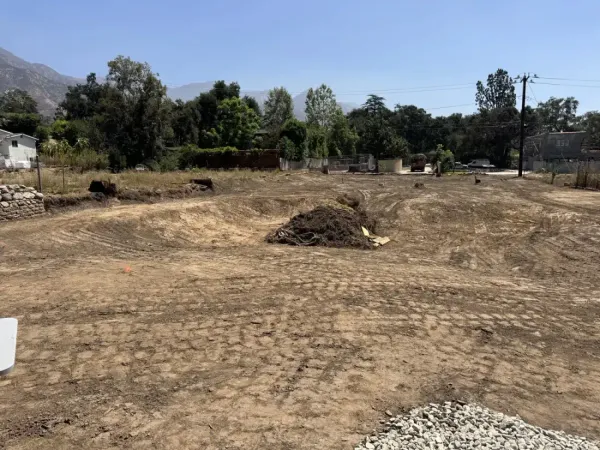

Cleared and graded building pad on a hillside lot showing rough earthwork with tire tracks from grading equipment, ready for footing excavation on the Altadena fire rebuild site. Orange staking flags mark property boundaries and drainage flow lines across the compacted dirt.

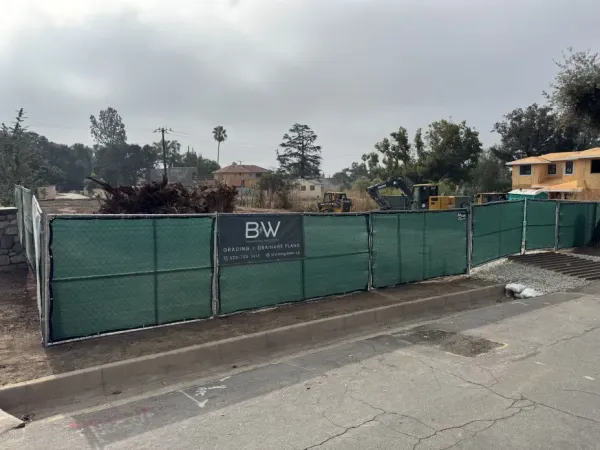

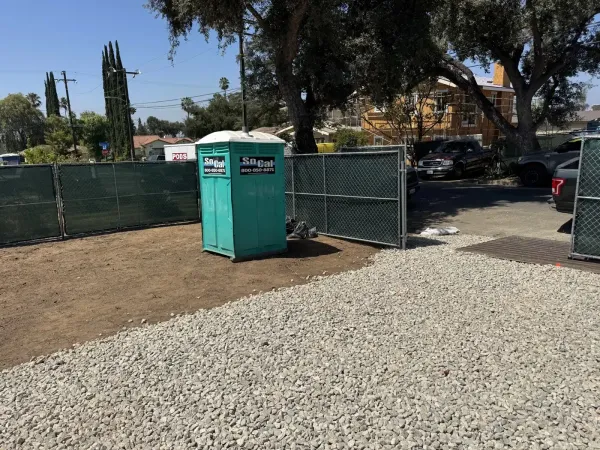

Temporary construction entrance with crushed rock base and green privacy fence along the property line for the multi-unit rebuild. Portable toilet and site security fencing indicate active construction phase on the Ganesha Avenue lot.

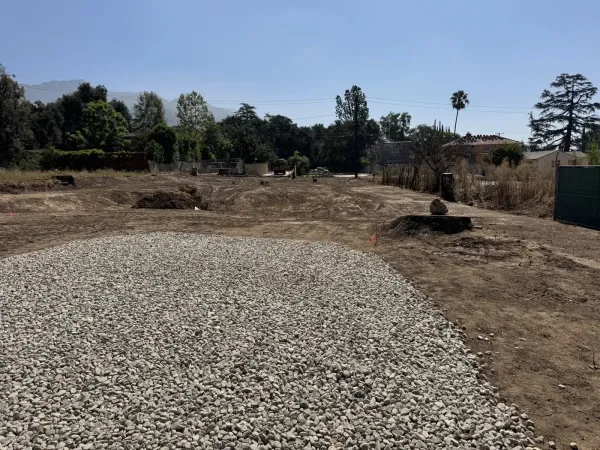

Compacted gravel base prepped for driveway and approach slab at the front of the fire rebuild lot. Rough grading extends toward the rear with minor grading swales directing stormwater runoff around future building pads.

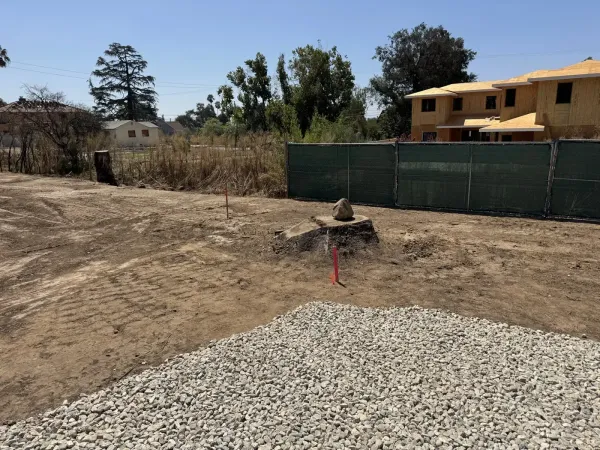

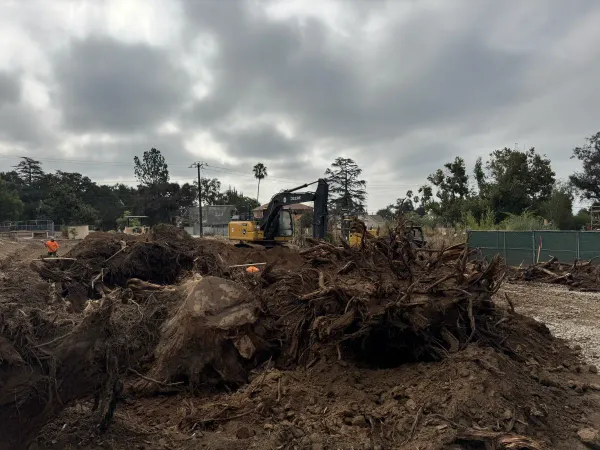

Tree stump marked with a survey stake and orange flag, preserved within the cleared construction zone for grading reference during site work. New lumber-framed multi-unit structure visible on adjacent parcel shows neighboring fire rebuild progress.

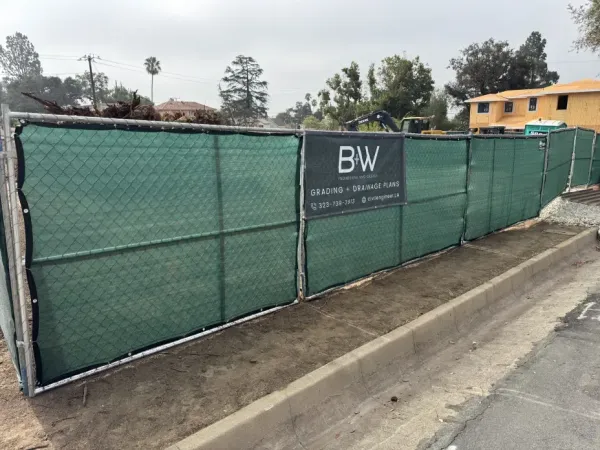

Construction site photo of the Altadena multi-unit fire rebuild on Ganesha Avenue
Construction site photo of the Altadena multi-unit fire rebuild on Ganesha Avenue

Project Progress

October 2025

Initial Assessment

Existing conditions documented. Drainage patterns identified. Topography analyzed.

2025

Submittal Stage

Drainage plans, hydrology report, and street plans submitted to LA County for review.

April 2026

Street Plans Approved

Street plans approved by LDD.

July 2026

Under Construction

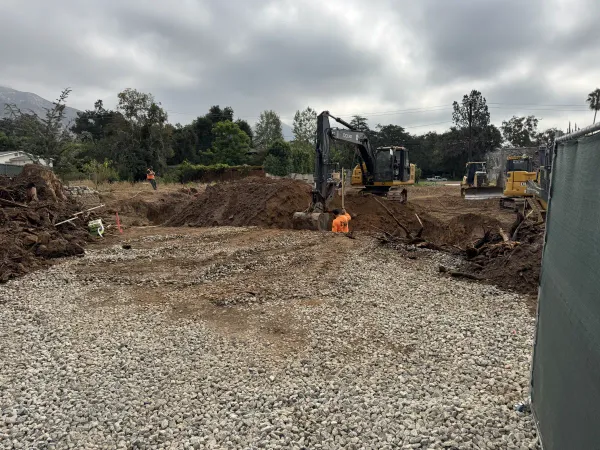

Site grading and construction underway. Building pad being prepared for foundation work.
